Project Overview
The County of Santa Cruz is replacing the San Lorenzo Way Bridge over the San Lorenzo River in Felton. Built in 1920, the existing single-lane bridge is structurally deficient, vulnerable to erosion around its foundation during high water flows, and does not meet current bridge and roadway design standards. The bridge has been identified for replacement through the federal Highway Bridge Program since 2010.
The project will replace the existing bridge with a modern two-lane concrete bridge. The new bridge will include concrete barriers on both sides and a sidewalk on the south side. The project will also improve the approach from Highway 9 and correct the steep grade onto San Lorenzo Way.
The new bridge will:
- Provide two lanes for vehicle traffic
- Include a new sidewalk on the south side
- Meet current bridge and roadway design standards
- Improve the approach to San Lorenzo Way from Highway 9
- Reduce the steep grade approaching the bridge
Construction is expected to begin in September 2026 and final project completion in Spring 2028. Work hours: 7:30 AM - 5:00 PM (Monday-Friday)
Anticipated Project Timeline
1
September 2026
Site Preparation
Environmental protective measures, tree removal, and clearing and grubbing, Intermittent weekday detours enacted.
2
October 2026
Utility Relocations
Electrical and communication utilities are relocated, Intermittent weekday detours enacted.
3
Oct. 2026–Apr. 2027
Work Stoppage
Construction activities pause during this period due to environmental permit restrictions.
4
April 2027
Bridge Closure
Temporary utility relocations begin. San Lorenzo Way closes with no public access.
5
May 2027
Bridge Demolition
The existing bridge is demolished.
6
June–October 2027
Bridge Construction
New bridge construction, utility work, paving, grading, erosion control and planting.
7
October 2027
New Bridge Complete
The new bridge is complete and San Lorenzo Way reopens.
8
Spring 2028
Construction Closeout
Final construction closeout activities are completed.
Project dates are estimates and subject to change. Inclement weather may impact the delivery schedule.

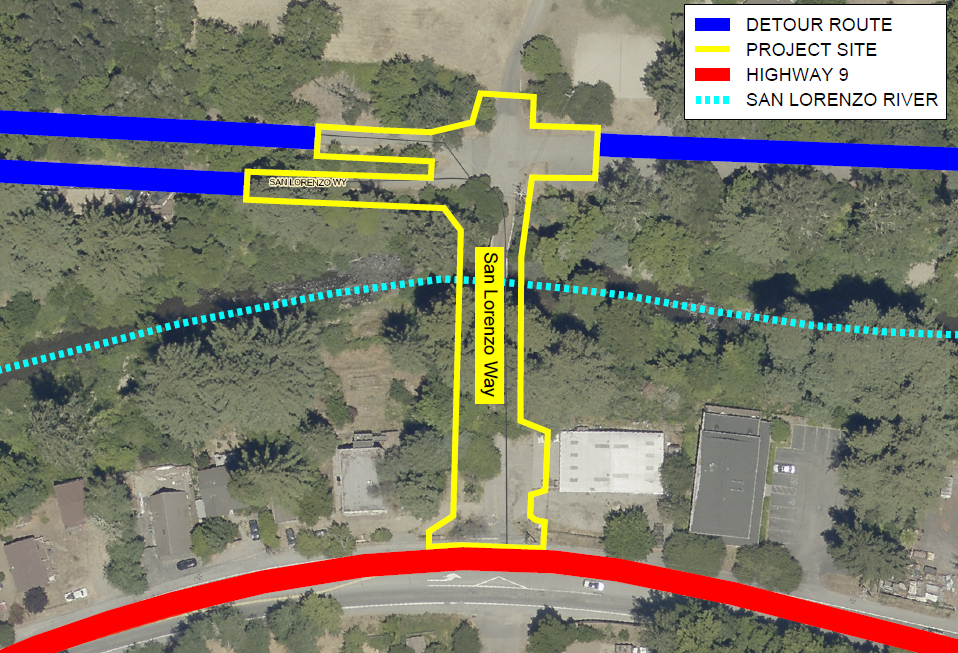

Detour

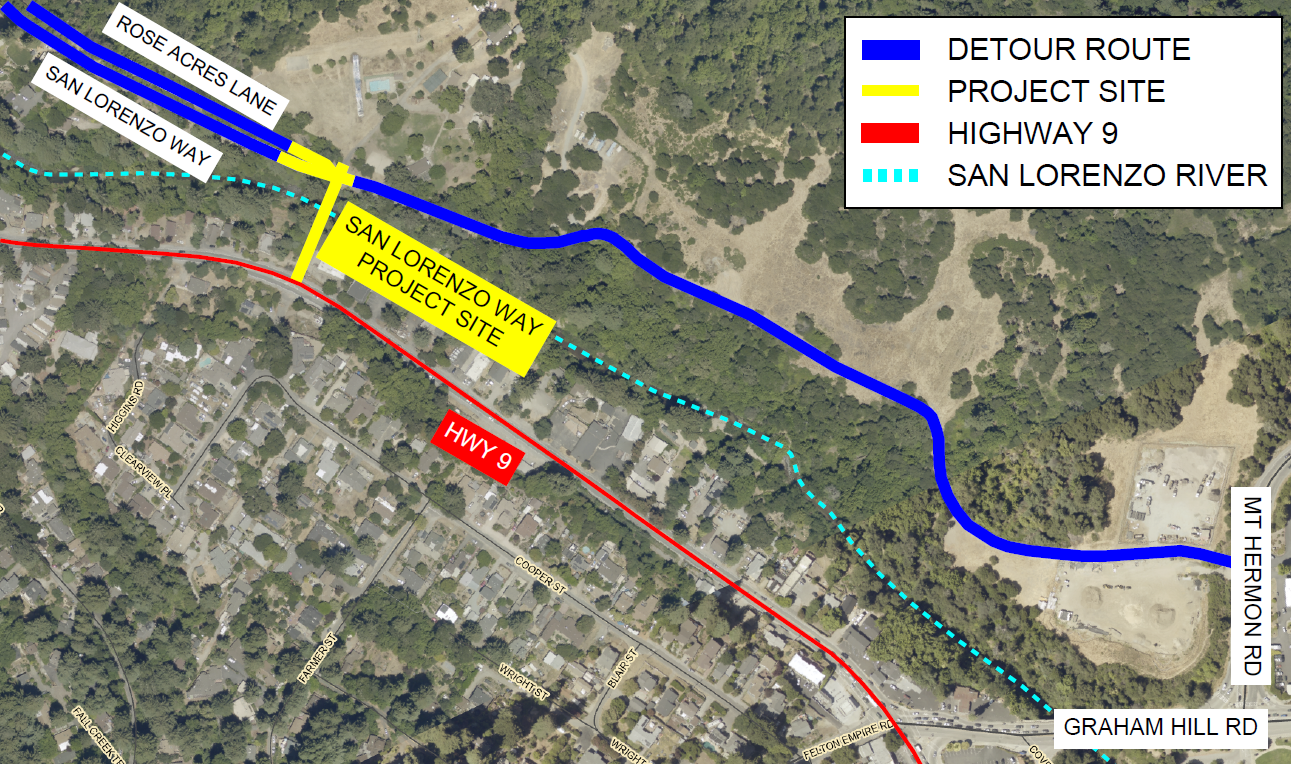

Intermittent detour routes between September - October 2026 will be provided using an existing private road on the east side of the San Lorenzo River that connects to Mount Hermon Road. Spring 2027 existing bridge will be closed until October 2027. Detour route provided.
Click the images to view a larger version.

Additional information about the construction schedule, detour and project updates will be provided as the project progresses.
Project Contact
For questions about the project, please contact the appropriate person below based on your specific question or need.
